Foreign-Trade Risks, Mitigation and Export Credit Insurance - Article

This article explains the major risks in international trade and the methods exporters and banks use to control them. It covers commercial, political, country, bank, documentary, currency and operational risks, along with export credit insurance and ECGC’s role. It helps CAIIB BFM learners understand how risk identification, mitigation and insurance work together in export transactions.

Free preview 14 min read 13 views English
Published
In this article

Introduction

International trade exposes exporters, importers and banks to risks that are often greater than those in domestic business.

An exporter may ship goods correctly but still fail to receive payment because:

  • the overseas buyer becomes insolvent;

  • the buyer delays or refuses payment;

  • political events prevent remittance;

  • exchange controls block transfer of funds;

  • the LC-opening bank fails;

  • documents contain discrepancies; or

  • exchange rates move adversely.

The current IIBF CAIIB BFM Module A syllabus specifically covers Risks in International Trade, Country Risk, Export Credit Insurance, ECGC Role and Products, ECGC Policies, Products for Banks, compliance points and claims.

For CAIIB, the basic approach is:

Identify the risk → reduce the risk → transfer or insure the remaining risk where appropriate.

Export credit insurance is therefore one part of risk management. It does not replace proper buyer appraisal, documentation, hedging or recovery action.

Learning Objectives

After studying this topic, you should be able to:

  • Identify major risks in international trade.

  • Distinguish commercial risk from political and country risk.

  • Explain practical methods of mitigating foreign-trade risks.

  • Distinguish export credit insurance from cargo insurance.

  • Explain the role of ECGC in supporting exporters and banks.

  • Understand important limitations and obligations under export credit insurance.

Why Foreign Trade Carries Additional Risk

Domestic trade normally takes place:

  • within one legal system;

  • in the same currency;

  • with easier access to information; and

  • without cross-border transfer restrictions.

International trade adds uncertainty relating to:

  • foreign buyers;

  • overseas banks;

  • different currencies;

  • political boundaries;

  • country regulations;

  • transport over long distances;

  • documentary requirements; and

  • foreign-exchange controls.

Therefore, the creditworthiness of the buyer alone is not enough to assess an export transaction.

1. Commercial or Buyer Risk

Commercial risk arises mainly from the financial condition or behaviour of the overseas buyer.

Typical events include:

  • insolvency of the buyer;

  • prolonged failure to pay;

  • deterioration in the buyer’s financial position; and

  • wrongful refusal to accept exported goods.

ECGC’s Shipments Comprehensive Risks Policy recognises buyer insolvency, failure to pay within the prescribed policy period and wrongful non-acceptance among the commercial risks that may be insured, subject to policy terms.

Example

An exporter supplies goods on 90-day credit.

Before payment becomes due, the overseas buyer becomes insolvent.

The primary risk is commercial risk.

Mitigation

Commercial risk can be reduced through:

  • buyer credit appraisal;

  • credit reports;

  • conservative credit limits;

  • advance payment;

  • shorter credit periods;

  • confirmed LC;

  • bank guarantee;

  • factoring or forfaiting where suitable; and

  • export credit insurance.

2. Political Risk

Political risk arises from political, governmental or sovereign events outside the normal commercial control of the exporter and buyer.

ECGC policy wording recognises political-type events such as:

  • restrictions preventing transfer of payment;

  • war between countries;

  • civil war, rebellion or revolution;

  • prohibition on import of goods;

  • cancellation of an existing import authority; and

  • certain costs arising from interruption or diversion of voyage.

Example

The overseas buyer has adequate money and wants to pay.

However, the buyer’s government imposes exchange restrictions preventing transfer of foreign currency to India.

The loss arises primarily from political/transfer risk, not from buyer insolvency.

Mitigation

Possible safeguards include:

  • assessment of country exposure;

  • ECGC cover;

  • confirmed LC from an acceptable bank;

  • diversification across countries;

  • shorter payment terms;

  • sovereign or bank guarantees where appropriate; and

  • continuous monitoring of political developments.

3. Country Risk

Country risk is broader than the credit risk of one buyer.

It represents the possibility that conditions in a particular country may adversely affect several buyers, banks or transactions at the same time.

Factors include:

  • political instability;

  • foreign-exchange shortage;

  • external debt stress;

  • sovereign default;

  • exchange controls;

  • restrictions on capital transfers;

  • war or civil disturbance; and

  • serious economic deterioration.

A strong buyer can therefore become unable to pay because of conditions in its country.

ECGC periodically classifies countries according to risk. Its current FY 2026–27 country-risk information includes classifications effective from 1 July 2026.

4. Bank Risk

International trade frequently depends on overseas banks.

An exporter may receive an LC and assume that payment risk has disappeared.

That is not always correct.

The exporter can still face:

  • issuing-bank insolvency;

  • issuing-bank default;

  • country risk affecting the issuing bank; or

  • restrictions preventing the issuing bank from remitting funds.

Mitigation

Important safeguards include:

  • assessing the issuing bank;

  • obtaining confirmation from an acceptable confirming bank;

  • checking country exposure;

  • setting bank limits; and

  • obtaining appropriate ECGC cover where available.

Some ECGC exporter policies cover specified LC-opening-bank risks in addition to buyer and political risks.

5. Documentary Risk

Many international transactions are documentary.

Under a Letter of Credit, payment depends on a complying presentation, not merely on satisfactory shipment of goods.

Documentary risk may arise from:

  • late shipment;

  • late presentation;

  • inconsistent information;

  • incorrect invoice;

  • defective transport document;

  • insufficient insurance document;

  • missing certificate; or

  • failure to follow LC conditions.

Mitigation

The exporter should:

  • scrutinise the LC immediately;

  • seek amendment before shipment if necessary;

  • coordinate with carrier, insurer and inspection agencies;

  • prepare documents carefully;

  • use experienced trade-finance staff; and

  • present documents early.

Documentary compliance and credit insurance address different risks.

6. Foreign-Exchange Risk

An exporter may invoice in a foreign currency but incur most costs in rupees.

If the foreign currency depreciates before realisation, the exporter may receive fewer rupees than expected.

Similarly, an importer may have to pay substantially more rupees if the foreign currency appreciates.

Mitigation

Currency risk may be managed through permitted instruments such as:

  • forward contracts;

  • options;

  • swaps where appropriate; and

  • natural hedging.

Export credit insurance generally protects credit/payment risk, not adverse exchange-rate movement.

ECGC’s Shipments Comprehensive Risks Policy specifically excludes loss arising from adverse exchange-rate fluctuation.

7. Transport and Cargo Risk

Goods can be:

  • damaged;

  • destroyed;

  • lost;

  • stolen; or

  • affected by an accident during transit.

These are principally cargo or marine risks.

They should normally be covered through appropriate marine/cargo insurance.

Export Credit Insurance Is Different

Export credit insurance deals mainly with the risk of non-payment of export receivables.

Marine insurance deals with physical loss or damage to goods.

Basis

Export Credit Insurance

Marine/Cargo Insurance

Main Risk

Non-payment of export receivable

Physical loss/damage to goods

Typical Cause

Buyer insolvency, default, political event

Accident, fire, theft, transit damage

Main Subject

Export credit/payment

Goods in transit

ECGC Role

Major export credit insurer

Not a substitute for normal cargo insurance

Exporter and importer may operate under different legal systems.

Problems may arise from:

  • unclear contract terms;

  • dispute over quality;

  • dispute over specifications;

  • uncertain governing law;

  • difficulty enforcing judgments; or

  • different interpretation of contractual obligations.

Mitigation

Use:

  • clear written contracts;

  • suitable governing-law clauses;

  • arbitration provisions;

  • clear technical specifications;

  • agreed Incoterms®;

  • proper dispute-resolution clauses; and

  • professional legal advice for significant transactions.

Important ECGC Point

Credit insurance should not be assumed to cover every contractual dispute.

For example, ECGC’s SCR wording excludes certain losses where the buyer withholds payment because of disputes concerning quality, quantity, specifications or delivery, unless the applicable policy conditions for overcoming that exclusion are met.

9. Fraud Risk

International trade can involve:

  • fictitious buyers;

  • forged documents;

  • fraudulent bills of lading;

  • duplicate financing;

  • false invoices;

  • collusion; or

  • diversion of funds.

Mitigation

Banks should apply:

  • KYC and customer due diligence;

  • transaction monitoring;

  • buyer and supplier verification;

  • document authentication;

  • sanctions screening;

  • maker-checker controls; and

  • verification of unusual trade patterns.

Insurance does not replace normal prudence or fraud controls.

10. Operational and Compliance Risk

Foreign-trade transactions involve multiple deadlines and regulatory requirements.

Operational loss may arise from:

  • incorrect LC issuance;

  • wrong exchange rate;

  • missed presentation date;

  • late discrepancy notice;

  • incorrect EDPMS reporting;

  • sanction violation;

  • poor documentation; or

  • failure to comply with FEMA.

Mitigation

Banks should maintain:

  • trained trade-finance staff;

  • standard operating procedures;

  • maker-checker controls;

  • system-based diary controls;

  • reconciliation;

  • regulatory monitoring; and

  • clear escalation procedures.

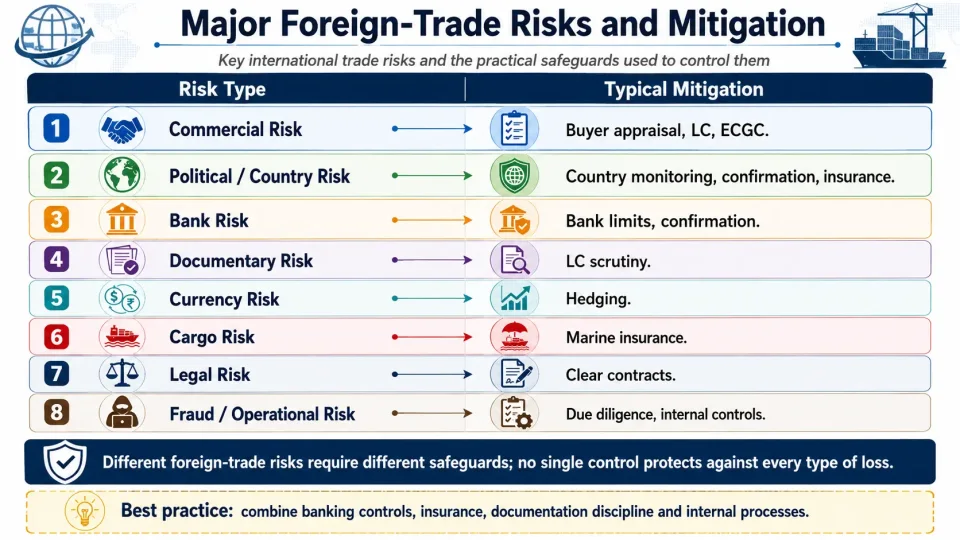

Risk matrix showing major international trade risks and the appropriate banking, insurance and operational methods used to mitigate them.
Different foreign-trade risks require different safeguards; no single control protects against every type of loss.

What Is Export Credit Insurance?

Export credit insurance protects an exporter against specified loss arising when an overseas receivable is not paid because of insured commercial or political risks.

It allows an exporter to sell on credit with greater confidence.

It may also help the exporter obtain bank finance because a substantial part of the payment risk has been transferred to an insurer.

However, insurance normally covers only an agreed percentage of eligible loss.

The exporter therefore retains some risk.

This encourages:

  • careful buyer selection;

  • proper recovery effort;

  • disciplined credit management; and

  • avoidance of reckless sales.

Role of ECGC

ECGC Limited is a Government of India enterprise providing export credit insurance and related support.

Its role broadly includes:

  • insuring exporters against specified commercial and political risks;

  • providing policies suited to different export structures;

  • providing export credit insurance covers to banks;

  • assessing overseas buyer and country risks;

  • supporting export credit flow; and

  • handling eligible claims and recoveries.

ECGC currently offers multiple short-term and medium/long-term products for exporters as well as separate Export Credit Insurance for Banks products.

ECGC Cover for Exporters

An important standard product is the Shipments Comprehensive Risks Policy (SCR).

ECGC’s current product information states that SCR:

  • is a whole-turnover declaration-based policy;

  • is normally issued for 12 months;

  • covers commercial/buyer risk;

  • covers political risk;

  • can cover specified LC-opening-bank risk; and

  • currently provides 90% cover under the product.

ECGC also offers other products for different needs, including:

  • Small Exporters Policy;

  • Specific Shipment Policy;

  • Export Turnover Policy;

  • Export Specific Buyers Policy;

  • Buyer Exposure Policy;

  • services-related policies; and

  • medium/long-term export policies.

The appropriate policy depends on factors such as:

  • size of exporter;

  • turnover;

  • buyer concentration;

  • type of export;

  • credit period; and

  • whether selective or whole-turnover protection is required.

ECGC Cover for Banks

Banks face a different risk from exporters.

When a bank grants:

  • Packing Credit; or

  • post-shipment export finance,

its direct borrower is normally the exporter.

The bank may suffer loss if the exporter fails to repay the export advance.

ECGC therefore has separate Export Credit Insurance for Banks (ECIB) products.

Current ECGC product categories include:

  • Individual Packing Credit;

  • Whole Turnover Packing Credit;

  • Branch-wise Packing Credit;

  • Individual Post-Shipment cover;

  • Whole Turnover Post-Shipment cover; and

  • specified surety/performance-related covers.

For example, the current Whole Turnover Packing Credit ECIB wording protects the insured bank against an agreed percentage of loss on eligible Packing Credit arising from specified exporter-borrower default or insolvency, subject to the policy conditions.

Important Distinction

Exporter’s ECGC policy protects the exporter against specified overseas payment risks.

ECIB cover protects the lending bank against specified loss on export credit granted to the exporter.

Do not confuse the two.

Exporter’s Responsibilities under ECGC Cover

Obtaining insurance does not mean that the exporter can stop managing the risk.

Typical ECGC policy obligations include:

  • proper disclosure of material facts;

  • obtaining required buyer/LC-opening-bank credit limits;

  • payment of premium;

  • timely declaration of shipments;

  • timely reporting of overdue payments;

  • taking reasonable steps to minimise loss;

  • stopping further exposure where serious adverse information arises;

  • taking recovery or legal action where necessary;

  • filing claims within the policy period; and

  • sharing subsequent recoveries with ECGC according to policy terms.

For SCR, current ECGC information specifically requires monthly shipment declarations, overdue-payment reporting, recovery action and sharing of recovery.

What Export Credit Insurance Does Not Mean

Several misconceptions are common.

It Does Not Guarantee 100% Recovery

Insurance generally covers only the specified percentage of eligible loss.

It Does Not Replace Buyer Appraisal

An exporter should still assess the buyer and control credit exposure.

It Does Not Cover Every Business Dispute

Contractual disputes, quality issues and circumstances specifically excluded by the policy can affect cover.

It Does Not Replace Marine Insurance

Physical damage to goods requires appropriate cargo insurance.

It Does Not Cover Currency Loss

Adverse exchange-rate fluctuation is a separate risk requiring foreign-exchange risk management.

It Does Not Remove Recovery Responsibility

The insured must continue reasonable recovery and loss-minimisation efforts.

Risk Mitigation: Match the Tool to the Risk

Risk

Important Mitigation

Buyer insolvency/default

Credit appraisal, limits, advance payment, LC, ECGC

Political/country risk

Country monitoring, confirmation, ECGC

Issuing-bank risk

Bank assessment, confirmation, ECGC where applicable

Documentary risk

Careful LC drafting and document scrutiny

Currency risk

Forward, option, swap or natural hedge

Cargo risk

Marine/cargo insurance

Legal risk

Strong contract and dispute-resolution clauses

Fraud risk

Due diligence, authentication and monitoring

Operational risk

Controls, trained staff and system alerts

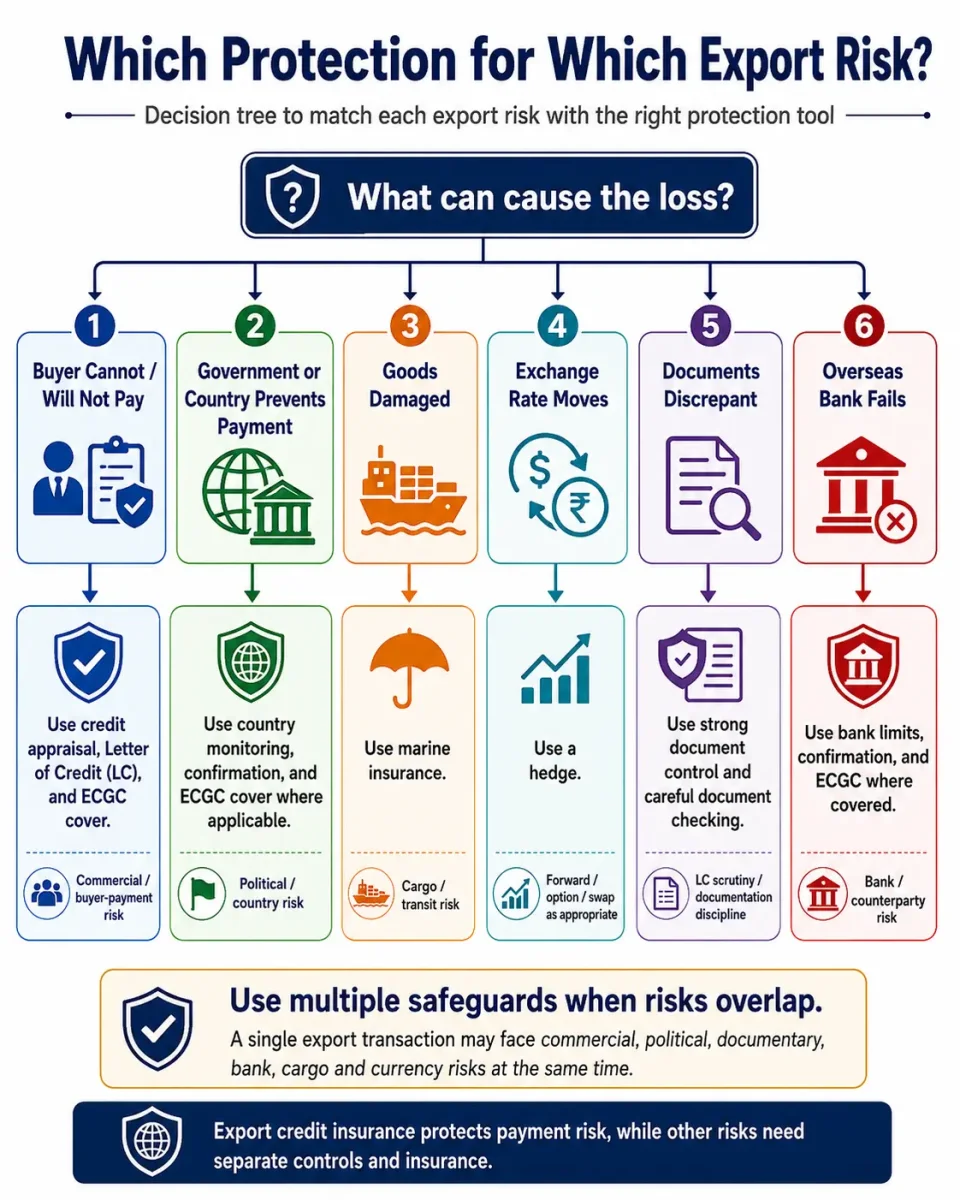

Decision tree showing which risk-management tool is suitable for buyer, political, cargo, currency, documentary and bank risks in exports.
Export credit insurance protects payment risk, while other risks need separate controls and insurance.

Practical Banking Application

Consider an Indian exporter proposing to sell goods worth a substantial amount to a new overseas buyer on 120-day open-account terms.

The banker should not evaluate the proposal only from the exporter’s financial statements.

The bank should consider:

Buyer Risk

  • Who is the buyer?

  • What is its credit history?

  • Is an ECGC buyer limit available?

Country Risk

  • Is the destination politically and economically stable?

  • Are transfer restrictions possible?

Payment Structure

Could risk be reduced through:

  • advance payment;

  • LC;

  • confirmation; or

  • shorter credit terms?

Currency Risk

Is the receivable exposed to adverse exchange-rate movement?

Export Credit Insurance

Is suitable ECGC cover available?

Bank Exposure

If the bank finances the export receivable, does it also require an appropriate ECIB arrangement according to its policy?

This demonstrates that strong trade-risk management normally uses several safeguards together.

CAIIB Exam Focus

Remember these high-value concepts:

  • Foreign-trade risk is broader than buyer credit risk.

  • Commercial risk includes buyer insolvency and specified payment default.

  • Political risk arises from sovereign or political events outside normal commercial control.

  • Country risk can affect even a financially sound buyer.

  • An LC reduces buyer risk but does not automatically eliminate issuing-bank or country risk.

  • Confirmation can reduce issuing-bank and certain country risks for the beneficiary.

  • Documentary risk requires document control, not credit insurance alone.

  • Currency risk should normally be managed through hedging, not ECGC.

  • Marine insurance and export credit insurance protect against different risks.

  • ECGC provides export credit insurance to exporters and separate ECIB covers to banks.

  • SCR currently covers commercial/buyer, political and specified LC-opening-bank risks and provides 90% cover under the current product framework.

  • ECGC country-risk classification is dynamic and should not be treated as permanently fixed.

  • Insurance cover is subject to policy terms, exclusions and insured obligations.

  • Claim payment does not end recovery responsibility; subsequent recoveries may have to be shared.

Common Exam Traps

Trap 1: “Buyer Insolvency Is a Political Risk”

Incorrect.

It is primarily a commercial/buyer risk.

Trap 2: “A Strong Buyer Eliminates Country Risk”

Incorrect.

Government restrictions or political disturbances can prevent payment despite the buyer being financially sound.

Trap 3: “LC Eliminates Every Export Risk”

Incorrect.

Issuing-bank risk, country risk, documentary risk and other risks can remain.

Trap 4: “ECGC Protects Goods against Transit Damage”

Incorrect.

Physical transit damage is normally a marine/cargo insurance risk.

Trap 5: “ECGC Protects the Exporter against Rupee Appreciation”

Incorrect.

Adverse currency movement is an exchange-rate risk and is not covered merely through export credit insurance.

Trap 6: “Every Buyer Dispute Is Automatically Covered”

Incorrect.

Contractual disputes concerning matters such as quality, quantity or specifications can affect policy cover.

Trap 7: “Exporter’s ECGC Policy and Bank’s ECIB Cover Are the Same”

Incorrect.

One primarily protects the exporter’s eligible receivable risk; the other protects the bank against specified loss on export credit.

Trap 8: “Once ECGC Cover Is Taken, Recovery Action Is Unnecessary”

Incorrect.

Loss-minimisation and recovery obligations continue under the applicable policy.

Memory Technique

Remember C-P-B-D-F:

  • C – Commercial: buyer insolvency or default

  • P – Political: government, war or transfer restrictions

  • B – Bank: overseas/LC-opening-bank failure

  • D – Documentary: non-compliant trade documents

  • F – Forex: adverse currency movement

Then choose the correct safeguard for each risk rather than assuming ECGC covers everything.

Back to Foreign-Trade Risks, Mitigation and Export Credit Insurance
